Project Description

The Belledune Port Authority (BPA) is advancing a phased marine terminal expansion that will establish the Port of Belledune as a strategic Canadian transportation and logistics hub for critical minerals, northern mine supply, liquid bulk products, and international trade.

The project supports Canada’s objectives of strengthening national supply chains, increasing transportation resilience, and diversifying trade beyond US markets.

Current project cost and metric baseline

Phase 1 capital program

$ 0 M

Phase 2 capital program

$ 0 B

Total project cost

$ 0 B

Throughput cases

0 MT /
0 MT

Cost estimate status

Phase 2 involves the development of a new deepwater transshipment terminal capable of accommodating Baby Capesize and Capesize vessels ranging from 120,000 to 180,000 DWT, creating the only facility of its kind on Canada’s east coast.

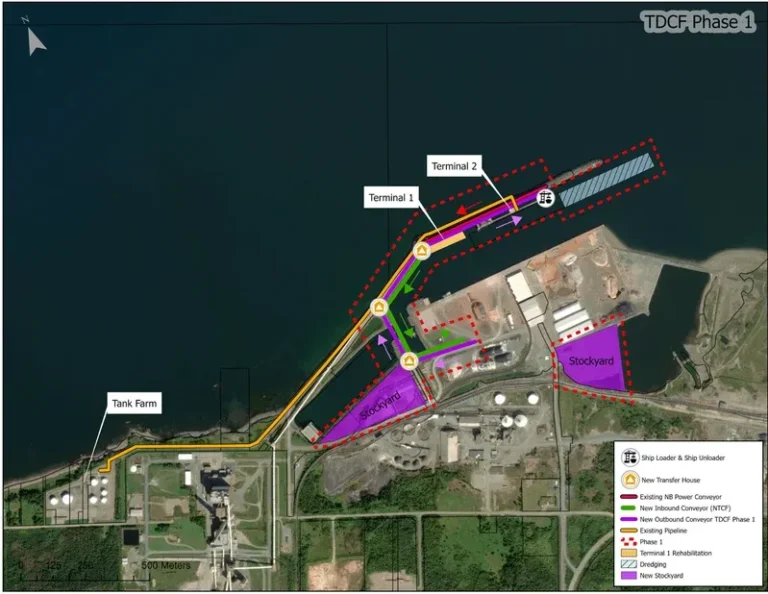

Phase 1 – Terminal 2 Optimization and Transshipment Readiness

The first phase of this project focuses on enhancing BPA’s deepest berth, Terminal 2, where an existing conveyor system is currently being enhanced.

CAPEX$347M
Primary objectiveEnhance near-term import/export and transshipment capability at
Terminal 2
Core worksParallel reverse-flow conveyor; dredging; Terminal 1 foundational
work; 5,000 t/hr shiploader; two 2,500 t/hr ship unloaders; mobile
stockyard equipment; added storage
Vessel capabilityFully laden Panamax or partially laden Baby Capesize vessels, up to
approximately 130,000 MT
Incremental
throughput
Increase throughput of 148% from 2025 to 2032
TimingDesign and approvals begin in 2026; commissioning is targeted
around early 2029, with project close-out extending into 2029
Strategic roleCreate near-term operating utility and incremental commercial
capacity while establishing infrastructure that supports the future
Terminal 5 build

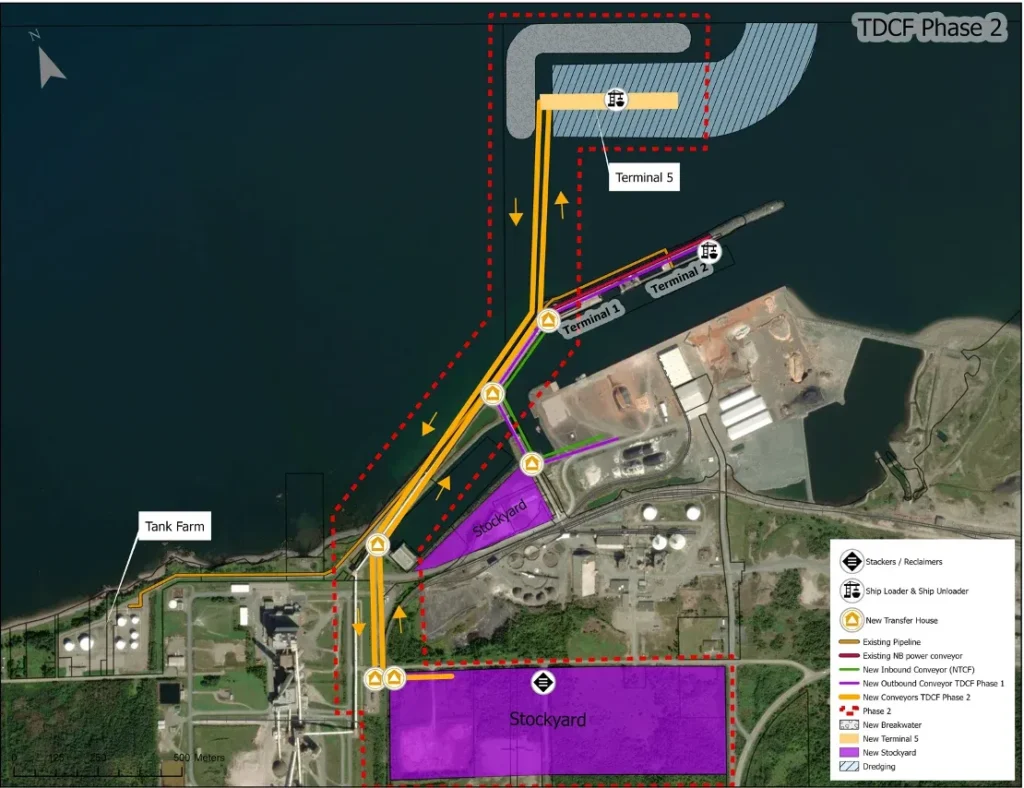

Phase 2 – Dedicated Critical Minerals Transshipment Terminal

Phase 2 involves the development of a new deepwater transshipment terminal capable of accommodating Baby Capesize and Capesize vessels ranging from 120,000 to 180,000 DWT, creating the only facility of its kind on Canada’s east coast.

Primary objectiveCreate dedicated deepwater transshipment capacity for critical
minerals and other strategic bulk commodities
Core worksNew breakwater; approximately 400 m wharf; approximately 600 m
access trestle; dredging; four stockpiles; conveyors; two stacker-
reclaimers; shiploader; two ship unloaders
Vessel capabilityCapesize at the north berth; Panamax or Baby Capesize at the south
berth; design range cited at 120,000-180,000 DWT
Commercial
throughput case
7 MT/year base case used for project economics; 12 MT/year upside
case
Increase in throughput of 498% from 2025 to 2038
TimingDesign and approvals from 2026 through the late 2020s; major
construction concentrated in 2030-2032; commissioning targeted
around early 2033
Long-term roleEstablish a full-scale Atlantic transshipment hub and platform for
future value-added industrial development
